Skip to main content
Guide

Walk-In Dismantling, Relocation & Reassembly

When moving an existing walk-in beats buying new, how dismantling and reassembly actually works, and how to plan the downtime around your operation.

5 min read

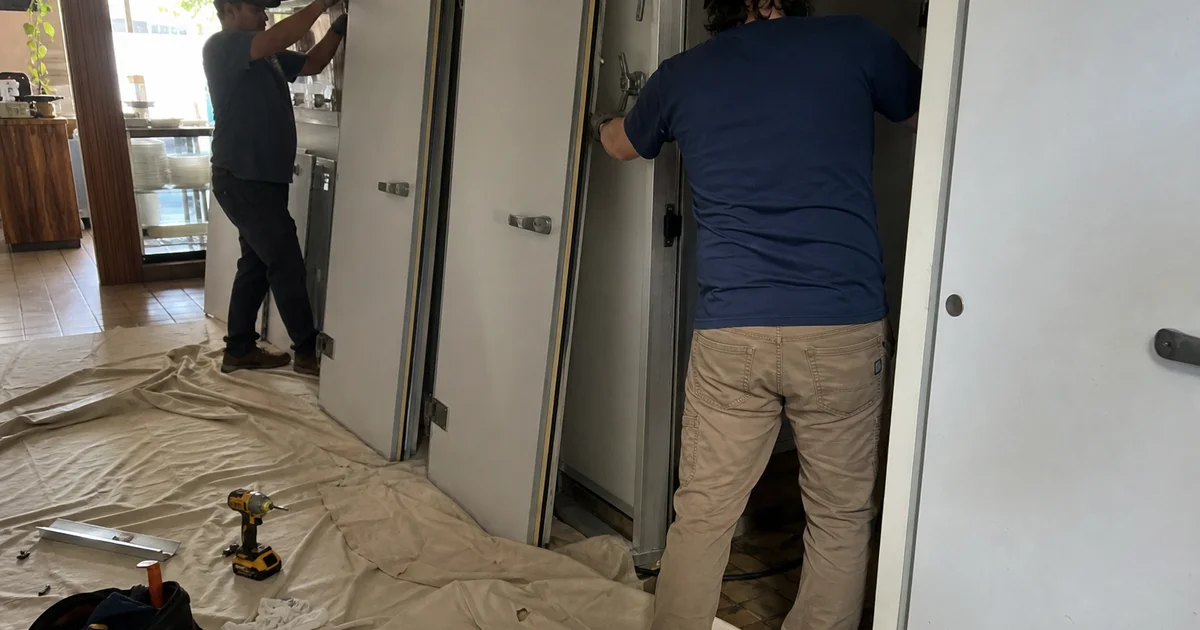

Crew disassembling walk-in cooler cam-lock panels during a Portland restaurant remodel

When Relocation Makes Sense

Three situations make relocating an existing walk-in the right call.

A remodel that moves the box across the room. The panels and door are fine, the refrigeration is fine, the new footprint just sits somewhere else. This is the clearest case and usually the cheapest option by a wide margin.

A move to a new address with a sound box. If you are relocating the operation and the walk-in has years of life left, taking it with you often beats buying new, provided the destination can accommodate it.

Acquiring a used box. Buying someone else’s walk-in and having it moved and reassembled can be very good value, but only after an honest condition assessment.

The situation where relocation does not make sense is a tired box. Panels with damaged vapor barriers, waterlogged insulation, cam-locks that no longer pull tight, or a door frame out of square are all reasons to put the money toward new panels instead. Our refrigeration construction team assesses condition before quoting reuse specifically so you are not paying to move a problem. If the comparison is close, commercial refrigeration build-out cost gives you the new-build figure to weigh the relocation against.

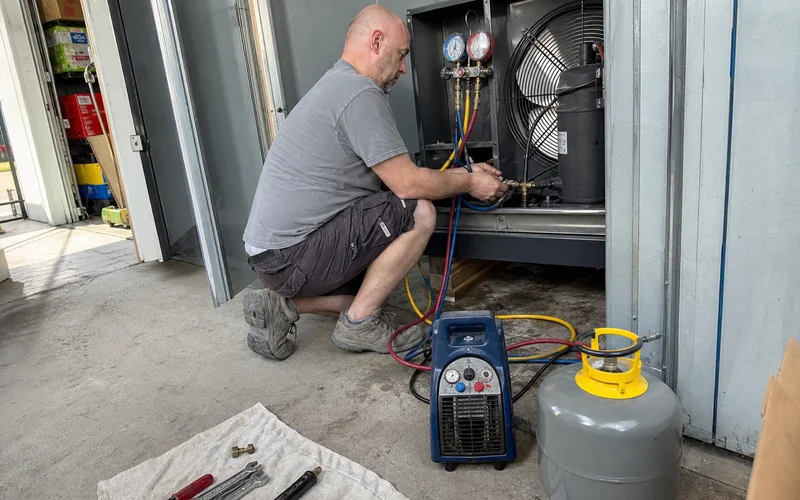

Technician recovering refrigerant from a condensing unit before dismantling

How the Work Actually Goes

Refrigerant recovery first. Before anything is disconnected, an EPA Section 608 certified technician recovers the refrigerant charge. Venting is prohibited, and this step is not skippable regardless of schedule pressure.

System disconnection. Electrical disconnect, refrigerant line separation and capping, drain line disconnection, and controls documented so the reassembly matches.

Panel labeling. Every panel gets numbered and its position recorded before removal. Walk-in panels are not interchangeable, particularly corner panels, door panels, and any that carry penetrations for lines or drains. Reassembling an unlabeled box is a slow, frustrating exercise in trial and error.

Careful dismantle. Cam-locks release from the inside with a hex key. Panels come apart in reverse order of assembly. The failure mode here is haste: forcing a panel damages the lock mechanism or the panel edge, and a damaged edge does not seal properly on reassembly.

Staging and transport. Panels stack flat and protected. Edge damage in transit is the most common way a relocation goes wrong.

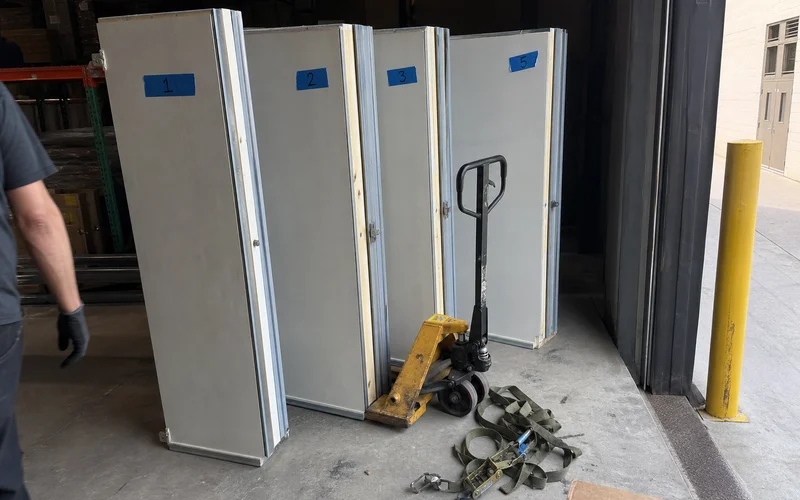

Numbered and labeled walk-in cooler panels staged on a loading dock for transport

Reassembly and Recommissioning

The destination has to be ready before panels arrive. Level slab, drainage sorted, electrical in place, condensing unit siting confirmed. A relocation stalls fastest when panels show up somewhere that is not prepped.

Reassembly follows the labeling in reverse, with fresh sealant at the joints and new gaskets where the old ones are tired. Panels that were fine in their original position will still leak if the joints are not re-sealed properly.

Then the refrigeration goes back: line runs, condensing unit set, evacuation, charge, and startup. Recommissioning means the same verification as a new build. Pull-down time, holding temperature under load, defrost cycle completion, and pressures checked at operating conditions.

Budget for the parts that always need replacing

Door gaskets, sweeps, sealant, and often the door closer. These are consumables that were probably tired before the move and will not improve during it. Replacing them during reassembly is cheap. Discovering they leak after everything is back together is not.

Planning the Downtime

The real question is not how long the physical work takes, it is what happens to your product in the meantime.

ScenarioTypical approach
Same-building move, short windowConsolidate into reach-ins, reduce ordering
Multi-day gapRental refrigeration or temporary box on site
New address, longer windowReduce inventory ahead, phase the move
Seasonal slow period availableSchedule into it, simplest option

We plan this as part of the quote rather than leaving it as your problem. If temporary cold storage is needed, it gets scoped up front so the number you see is the number you pay.

Moving or remodeling in the Portland Metro area? Talk to our construction team with the current box dimensions, its age, and where it needs to end up.

Assessing Whether the Box Is Worth Moving

Before quoting a relocation we look at five things, and any of them can change the recommendation.

Panel faces. Dents are cosmetic. Punctures are not, because they breach the vapor barrier and let moisture into the insulation core.

Cam-lock function. Locks that no longer pull a joint tight mean the reassembled box will leak air at that seam permanently.

Insulation condition. Panels that feel unusually heavy, or that show staining at the edges, may be waterlogged. Waterlogged panels have lost R-value and will not recover.

Door and frame. A frame out of square, worn hinges, or a door that has been forced will not seal after a move any better than it does now.

Floor. If the box has an insulated floor, its condition matters as much as the walls, and damage there is often hidden under shelving.

A box that passes all five is worth moving. A box that fails two or more usually is not, and we will say so rather than quote a move that leaves you with the same problems in a new location.

Sequencing Around a Remodel

Relocations rarely happen in isolation. They are part of a remodel with other trades involved, and sequencing matters.

Flooring, drainage, and electrical at the new location all need to be complete before panels arrive. If the walk-in goes in too early, other trades work around it and risk damaging it. Too late, and the box becomes the critical path for opening.

Tell us the remodel schedule and we will slot the work where it belongs rather than at whichever end is convenient.

Related service

Learn more about Construction & Installation

Full-scale project planning, design, and execution for new commercial refrigeration installations and expansions.

FAQ

Questions We Get About This

Can an old walk-in be reused after moving?
Often yes, if the panels are structurally sound, the cam-locks still engage properly, the vapor barrier is intact, and the door and frame are in reasonable shape. We assess condition before quoting reuse, because moving a box that should be replaced is money spent twice.
How long is the cooler down during a move?
It depends on distance and site readiness. A same-building relocation with the new location prepped can be a matter of days. A move to a new address adds transport and often permitting. We plan temporary cold storage around whatever the actual window turns out to be.
Does refrigerant have to be handled specially?
Yes. Refrigerant must be recovered by an EPA Section 608 certified technician before the system is disconnected. Venting it is prohibited. This is a required step, not an optional one, and it is part of any legitimate relocation quote.
Is relocating cheaper than buying new?
Usually, when the box is in good condition and the move is local. The savings shrink as panel condition worsens, transport distance grows, or the new site needs substantial preparation. On a box that is already near end of life, new equipment often wins on total cost of ownership.
